Measuring tm5U is often discussed as a straightforward "add LC–MS" problem (a term used interchangeably with tm⁵U in many search queries). In practice, it's closer to an interpretability problem: you're trying to quantify a low-abundance tRNA modification in a sample where RNA amount, RNA integrity, and matrix effects can dominate the result.

This article gives a feasibility-first framework for LC-MS measurement of mitochondrial tRNA modification (tm⁵U), with the controls and stop-loss checkpoints that prevent a "non-detect" from being misread as "no biology." The goal is not to promise that every matrix will work (plasma included), but to help you decide what is realistic, what to test first, and what you can claim responsibly.

A tm⁵U LC–MS project succeeds or fails on feasibility gates (sample type, enrichment, background) and interpretability controls (blanks, spikes, batches), not on instrument sensitivity alone.

tm⁵U in one page: what it is and why RNA modification mass spectrometry is non-trivial

tm⁵U (often written τm5U; 5‑taurinomethyluridine) is a taurine-containing wobble-position (U34) modification found on specific mitochondrial tRNAs. It's typically discussed in the context of mitochondrial translation fidelity and mt‑tRNA mutations that show hypomodification at wobble bases.

Two practical points matter for measurement design:

  1. You're usually not measuring "a site" unless you choose a site-specific method. Many LC–MS workflows quantify modified nucleosides after digestion. That tells you how much tm⁵U is present in the material you processed, but not which exact tRNA species (or which position) contributed to that signal.
  2. "Not detected" is a multi-cause outcome. Low starting RNA, degradation, incomplete recovery, ion suppression, carryover, or co-eluting interferences can all erase a real biological difference.

If you need a short biological anchor for tm⁵U's relevance (without turning this into a review), the canonical context is wobble modification deficiency in mitochondrial tRNAs and its translation consequences (e.g., the PNAS study on wobble taurine modification deficiency in mt‑tRNA, 2004: Codon-specific translational defect caused by a wobble modification deficiency (PNAS, 2004)).

Feasibility first: can mitochondrial tRNA modification (tm⁵U) be measured in your sample type?

Before you optimize MS parameters, decide whether your sample type can realistically support tm⁵U measurement at all. The feasibility question breaks into three gates:

  • Gate 1 — Material: Is there enough intact RNA/tRNA (or can you enrich it)?
  • Gate 2 — Background: Do blanks and matrix background allow confident detection?
  • Gate 3 — Repeatability: Can you reproduce detection/quantification across replicates and batches?

Feasibility decision flow for measuring tm⁵U by LC–MS across sample types, with stop-loss checkpoints and required controls.

Sample-type feasibility ranking (table-ready)

A practical way to plan is to rank sample types from "more feasible" to "more difficult," then pick the earliest matrix that can answer your biological question.

Feasibility tier Sample type (typical examples) Why it's more feasible What it lets you claim more safely
Most feasible Cultured cells (mitochondria-rich lines; patient fibroblasts) Higher RNA yield; controllable handling; easier enrichment Relative differences across conditions; method development and QC establishment
High Tissue (fresh/frozen biopsies; model organism tissues) Higher input than fluids; tissue-specific biology Relative differences across phenotypes; often publishable with strong QC
Moderate Isolated mitochondria / enriched fractions Improves target fraction; reduces dilution Stronger interpretability for "mitochondrial" claims
Challenging Whole blood / PBMCs Cellular material exists, but handling variability is high Feasibility depends on processing and stabilization workflow
Most difficult Plasma / serum / body fluids Very low RNA; mixed origin; high matrix complexity At best: feasibility demonstration under defined conditions; cautious interpretation

This ranking isn't a judgment of importance—it's a way to avoid spending your entire budget proving that your matrix is too hard.

What makes plasma especially challenging

Plasma feasibility is a common question, and the honest answer is: it's project-dependent, and "non-detect" is not automatically informative.

Why plasma/body fluids tend to be hard for tm⁵U:

  • Low RNA amount and fragmented RNA: Even if extracellular RNA exists, the fraction that is relevant to mitochondrial tRNA biology may be tiny.
  • Mixed biological origin: Plasma RNA can reflect multiple tissues and cell types; "signal dilution" is a real failure mode.
  • Matrix effects and co-elution: Ion suppression and background peaks can obscure a low-abundance modified nucleoside.
  • Handling sensitivity: Freeze–thaw, storage conditions, and extraction choices can dominate recovery.

If your scientific question truly requires plasma, feasibility should be treated as a pre-study with explicit stop-loss criteria.

Stop-loss micro-test before scaling

If you're not sure plasma (or any low-input matrix) will work, the fastest way to prevent sunk cost is a micro-test that answers three questions:

  1. Detectability: do you see a peak consistent with tm⁵U in a realistic injection regime?
  2. Background/blank: do process blanks and matrix blanks create confusing signals in the same window?
  3. Repeatability: do you see consistent presence/absence (or consistent quantitative behavior) across replicates?

A single "successful" injection is not feasibility. Feasibility means detection (or quantification) survives blanks, replicates, and batch boundaries.

In real projects, we're often asked "Is tm⁵U in plasma feasible?" Our first step is usually not a full cohort run—it's a deliberately small stop-loss test designed to prove interpretability before anyone commits to scale.

Sample preparation strategy (high-level, no brand names)

This section is intentionally not a step-by-step SOP. The goal is to highlight the prep decisions that most often determine success or produce false negatives.

At a high level, nucleoside LC–MS workflows for RNA modifications involve: (1) extracting RNA, (2) optionally enriching for the RNA class of interest (e.g., tRNA), (3) digesting to nucleosides, (4) desalting/cleanup to protect LC–MS performance, and (5) analyzing with appropriate controls. If you want a search-friendly label for this approach, it's often described broadly as tRNA modification LC-MS.

Two method families are common:

  • Nucleoside-level quantification (digest RNA to nucleosides; measure tm⁵U as a modified nucleoside). This is often the starting point for feasibility because it's comparatively robust and scalable.
  • Site-specific tRNA modification profiling (more complex strategies that can localize modifications). These methods exist (e.g., LC–MS/MS approaches for single-base profiling; Full‑Range Profiling of tRNA Modifications at Single‑Base Resolution (Analytical Chemistry, 2020)), but they may be disproportionate for an initial feasibility question.

RNA integrity and contamination control

Three common causes of downstream failure happen before LC–MS ever starts:

  • RNA degradation reduces recoverable signal and increases variability. This is amplified in low-input matrices.
  • Carryover and environmental contamination can create deceptive "peaks" in blanks.
  • Salt and detergent residues can suppress ionization and destabilize retention.

Practical guardrails:

  • Define acceptable handling windows (collection → stabilization → extraction) and record them as metadata.
  • Use process blanks alongside every extraction batch.
  • Treat cleanup/desalting as a sensitivity step, not just an "instrument protection" step.

If you need a good conceptual summary of where nucleoside LC–MS can go wrong (artifacts, biases, and false certainty), see the review: Pitfalls in RNA Modification Quantification Using Nucleoside Mass Spectrometry (Molecular Pharmaceutics, 2023).

Enrichment vs total RNA trade-offs

Enrichment isn't automatically "better." It changes the question.

Total RNA (or broad RNA fractions) can be useful when:

  • you're doing an early feasibility screen
  • you want a global view of RNA modification content
  • you're constrained by input and want to minimize handling steps

tRNA enrichment (or focused fractions) can be useful when:

  • you need interpretability that points toward tRNA biology
  • you suspect dilution from other RNA classes
  • you need to reduce background from abundant RNA species

The trade-off is that enrichment can introduce bias and loss. In low-input projects, a failed enrichment can look exactly like "no tm⁵U." That's why enrichment decisions should be paired with recovery checks and spikes (see Controls).

Common prep pitfalls that cause false negatives

The failure modes below are "silent"—they can produce clean chromatograms with the wrong biological conclusion:

  • Incomplete digestion (or digestion variability) that changes modified nucleoside release.
  • Loss during cleanup/filtration that is invisible unless you track recovery.
  • Batch-specific contamination or carryover that inflates background and hides low peaks.

Plan for at least one control that tests recovery (not just background). Otherwise, you can't distinguish "not present" from "not recovered."

Controls that make results interpretable

If the reader of your paper (or the customer of your report) has only one question, it's usually this: "If you didn't detect tm⁵U (or you saw no change), how do you know the method would have detected a real change?"

Controls answer that question.

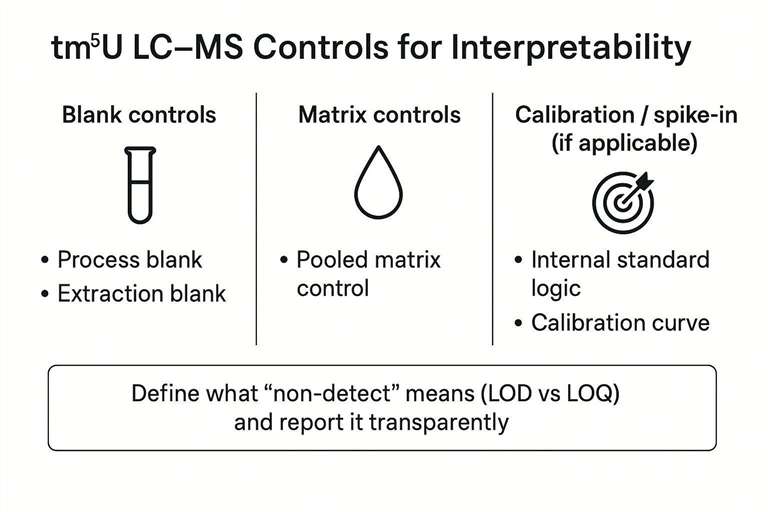

Control map for tm⁵U LC–MS projects: blanks, matrix controls, and calibration logic to avoid false negatives.

Core negative controls (process blanks, matrix blanks)

At minimum, feasibility and production runs should include:

  • Process blank: everything except biological material. This tells you whether reagents, tubes, enzymes, or handling introduce signals.
  • Extraction blank (if distinct from process blank): isolates the extraction step as a contamination source.
  • Matrix blank / pseudo-blank: a matrix that matches your samples as closely as possible but should not contain your analyte (or contains it at minimal level).

Why this matters specifically for tm⁵U:

  • tm⁵U is a modified nucleoside; low-level background or carryover can cause false positives.
  • In plasma/fluids, "background" can be complex and can overlap with where you expect low peaks.

A practical way to report this in a manuscript is to show a short panel: blank chromatograms aligned to sample chromatograms in the same retention window, plus a statement of how you defined absence.

Internal standards / spike-in logic (project-dependent)

A spike-in strategy doesn't have to be complicated, but it must be logically aligned to the question you want to answer.

You typically need to decide what you're trying to protect against:

  • Ionization and injection variability (instrument-side variation)
  • Extraction and digestion recovery (prep-side variation)
  • Matrix effects (matrix-specific suppression/enhancement)

Three common (and defensible) approaches:

  1. Instrument-side internal standard: added after digestion/cleanup to normalize injection and MS response.
  2. Process spike: added early (before extraction/digestion) to test end-to-end recovery.
  3. Matrix-matched spiking: tests whether the matrix background allows detection/quantification at relevant levels.

If your conclusion might be "non-detect," you need at least one spike-in experiment that demonstrates what would have been detected in that matrix under your workflow.

We avoid promising that any single standard is universally appropriate, because the best spike-in depends on whether you're measuring tm⁵U at the nucleoside level, whether you require absolute calibration, and what matrix you're working in.

Replicates and batch balancing

If you want your result to survive peer review (or internal governance), treat batch effects as a first-class variable.

Practical expectations:

  • Technical replicates help separate injection variability from biology.
  • Biological replicates are non-negotiable if you plan to claim a difference.
  • Batch balancing: distribute conditions across extraction and instrument batches so "condition" isn't confounded with "day."

Even with perfect MS performance, a confounded batch design can produce convincing—but wrong—differences.

Quantification and reporting: what you can claim responsibly

A tm⁵U LC–MS result can be scientifically useful without being "perfect." But it has to be framed correctly.

LOD vs LOQ in plain language

A practical way to explain this to collaborators:

  • LOD (limit of detection): "Can we reliably tell it's there, above blank?"
  • LOQ (limit of quantification): "Can we measure it with acceptable precision and accuracy?"

Many projects fail in communication because teams talk as if LOD and LOQ are interchangeable.

For a defensible baseline on how LoB/LOD/LOQ are defined and why blanks matter, a clear reference is: Limit of Blank, Limit of Detection and Limit of Quantitation (Clin Biochem Rev, 2008).

Relative vs calibrated reporting

There are two common reporting modes:

1) Relative reporting (comparative):

  • You report tm⁵U levels relative to a reference (e.g., normalized to canonical nucleosides or total nucleoside signal).
  • Strength: often feasible earlier; supports "condition A vs B" comparisons.
  • Risk: sensitive to recovery differences unless controlled.

2) Calibrated reporting (absolute):

  • You report concentrations or absolute amounts based on calibration and standards.
  • Strength: improves cross-batch and cross-study comparability.
  • Risk: requires standards, matrix-aware calibration, and more validation.

A common best practice is to start feasibility with relative reporting and move to calibrated quantification only if the project needs cross-study comparability.

For the broader methodological landscape (and why pitfalls and artifacts matter), see: Pitfalls in RNA Modification Quantification Using Nucleoside Mass Spectrometry (Accounts of Chemical Research, 2023).

How to report non-detects without over-claiming

Non-detects happen frequently in low-input matrices. The wrong way to write them is:

  • "tm⁵U was absent in plasma."

A more defensible pattern is:

  • "tm⁵U was not detected above the method LOD under the described extraction, digestion, and LC–MS conditions."

To make that statement meaningful, include:

  • what matrix you tested
  • how many replicates
  • what blanks you ran
  • whether a spike-in was detected as expected
  • what you mean by "not detected" (signal < LOD, or < LOQ, etc.)

If you need a biological discussion of wobble modification differences and how these modifications are analyzed (context, not an LC–MS SOP), see: Modification of the wobble uridine in bacterial and mitochondrial tRNAs (2015).

If you're specifically looking for LC–MS measurement approaches for τm5U/τm5s2U in mitochondrial contexts, a helpful starting point is the PMC-available RNA paper: Chemical synthesis of the 5‑taurinomethyl(‑2‑thio)uridine modified anticodon arm of human mitochondrial tRNAs (RNA, 2014).

Warning: If your spike-in is not reliably detected in plasma, you can't interpret a non-detect on endogenous tm⁵U as a biological finding. It's a method finding.

Data QC checklist for tm⁵U LC–MS projects

This is a reviewer-friendly checklist you can use as a "project acceptance" gate.

Minimum QC gates

  • Sample metadata complete: collection time, storage conditions, freeze–thaw count, extraction batch ID.
  • RNA yield and integrity recorded (as applicable to the matrix).
  • Blanks included: process blank and extraction blank per batch.
  • Carryover check: demonstrate that high-signal injections don't contaminate subsequent runs.
  • Spike-in behavior documented (if used): detected at expected retention time; repeatable.
  • Batch balancing documented: conditions distributed across batches.
  • LOD/LOQ statement: defined per matrix and described in plain language.

Rework triggers

If any of the following happen, treat them as a reason to pause and redesign before scaling:

  • Blank signals overlap the tm⁵U window in a way that changes across batches.
  • Replicates disagree on detect/non-detect.
  • Spike-in is not recovered consistently.
  • A single batch explains most of the apparent group difference.
  • Peak shape/integration is unstable near the decision threshold.

How we can help (consultation-only)

If you're evaluating mitochondrial tRNA modification measurement by LC–MS—especially when the sample type is low-input or plasma/body fluid—bring us the basics (sample type, sample count, what you need to claim, and whether plasma is mandatory). We can help you map a feasibility-first plan, define the control set, and set QC gates that make "detected" and "not detected" interpretable.

PTMs and nucleic acid MS modification services.

For readers specifically exploring nucleoside-level tRNA modification measurement options, you may also find this service overview useful: tRNA modification LC–MS analysis service.

For research use only. Not for clinical diagnosis.
